Financial Sustainability Analysis

Campaigns Navigation

Understanding the Township of Langley's financial development patterns and exploring sustainable alternatives for community growth.

2025 at a glance (audited financial statements, June 2026)

$584.4M
external debt, up 84% from $317.3M in one year
$131.2M
net debt, from $8.5M a year earlier
$202.9M
property tax revenue
$51.8M
DCCs received, the most on record

Source: Township of Langley 2025 Annual Report, Financial Section, pages 38 to 49.

Strong Towns Langley has identified significant concerns with the Township of Langley's approach to municipal finance and development strategy. What began as typical suburban sprawl issues, primarily single-family housing developments that generate insufficient tax revenue to cover their long-term infrastructure costs, has evolved into a pattern of increasingly risky financial strategies.

Our analysis reveals how the Township has employed several distinct approaches to address mounting financial and infrastructural deficits, each creating new challenges while attempting to solve previous ones. This cycle of financial dependency on growth raises important questions about long-term sustainability and fiscal responsibility.

This examination covers four distinct periods in our community's development history, showing how each financial strategy has led to the next. The Draft 2026-2030 Financial Plan reveals a municipality with borrowing capacity nearly exhausted, reserves being redirected from their intended purposes, and structural cost growth outpacing revenue.

Comprehensive Analysis

Strong Towns Langley logo
Is my town trapped in a Growth Ponzi Scheme?
Strong Towns Langley March 23, 2024

This comprehensive analysis examines how Township of Langley's development patterns have evolved from the 1980s through today's debt-financed infrastructure approach.

Phase 1: The 1980s Walnut Grove Experience

Learning the costs of infrastructure during economic downturns

The Township's transformation into a suburban community accelerated with the development of Walnut Grove and Murrayville in the early 1980s. This period established financial patterns that would influence municipal strategy for decades to come.

The 1982 Recession Impact

Just as Walnut Grove development was underway, the early 1980s recession hit. With interest rates spiking and development slowing, the municipality found itself carrying infrastructure costs for serviced but undeveloped lots.

The 1982 Municipal Stewardship Report documented this challenge:

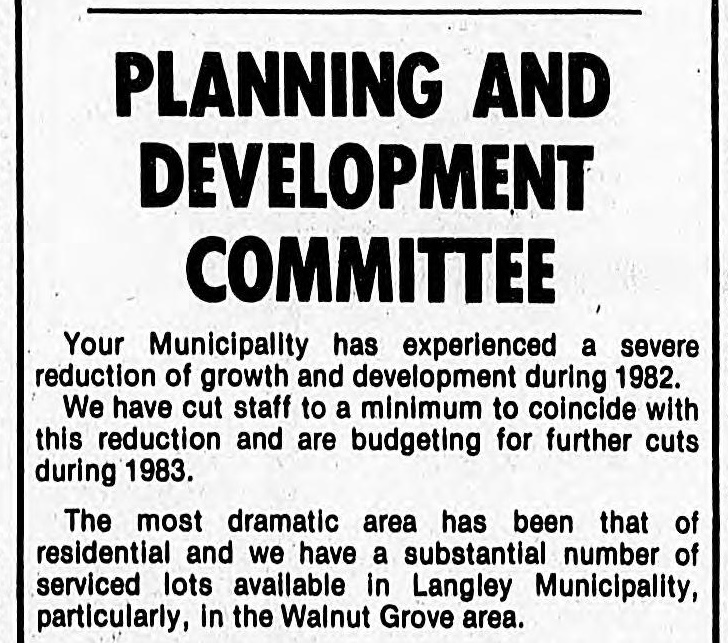

"We have a substantial number of serviced lots available in Langley Municipality, particularly in the Walnut Grove area."

1982 Municipal Stewardship Report
1982 Stewardship Report excerpt
Historical Documentation

1982 Municipal Stewardship Report documenting infrastructure challenges during the recession. Click to view full report.

Credit: UBC BC Historical Newspapers Archive

Long-term Implications

This experience of carrying infrastructure costs during economic downturns would later influence how the Township approached development financing. As Frances Bula documented in her analysis of Fraser Valley growth patterns, the municipality cited this incident as a reason for rejecting front-loading infrastructure investments, as "[financing] those up front [...] would be hard on local taxpayers".

However some argue this incident has been somewhat overblown, as Kurt Alberts, who served in the Township's planning department from the early 1980s to the mid 1990s, explained to Strong Towns Langley via email:

"I don’t believe the story regarding Township bankruptcy [paying for the infrastructure like roads/sidewalks/lights/water/sewer in Walnut Grove] has any credibility [...] For the most part infrastructure was a requirement of the developer(s) of each subsequent Neighbourhood."

But the impact to individual developers was significant:

"The recession that came in 1981 left whole subdivisions within Neighbourhood 2 fully serviced with no purchasers. Prior to the recession new vacant lots were selling for up to $70,000. The bottom literally fell out of the market and I'm sure many developers went bankrupt during that time. When new lots again finally came on the market a few years later, $69,000 got you a lot and a house."

Email from Kurt Alberts

Phase 2: "Grow Faster" - The Willoughby Strategy

2000s-2010s: Subsidizing development to accelerate growth

As infrastructure in older areas like Walnut Grove began reaching end-of-life in the 2000s, the Township adopted what Strong Towns founder Chuck Marohn identifies as a common municipal response to financial pressure.

The Municipal Response to Financial Pressure

Chuck Marohn, from his experience consulting with cities across North America, explains what he observed as the typical first response when municipalities face financial difficulties:

Development Results (2001-2016)
  • 800 new single-family homes
  • 10,000 ground-oriented units
  • 2,000+ new apartments

Source: Census data cited in Frances Bula's analysis

"The first thing cities do when they have financial trouble is they try to grow faster." - Chuck Marohn, Strong Towns (paraphrased)

The Development Fee Freeze Strategy (2007-2019)

To accelerate growth in Willoughby and Yorkson, development fees were frozen for 12 years. This strategy successfully achieved several objectives:

Achieved Goals
  • Rapid development in Willoughby/Yorkson
  • Increased property tax revenues
  • Attracted developers with low fees
  • Created denser, more urban communities
Trade-offs
  • Infrastructure gaps (incomplete 208 Street)
  • Missing sidewalks and arterial connections
  • Minimal community facilities
  • Deferred infrastructure maintenance
Key Insight: Given the emphasis on low fees and reduced costs, it's likely the intent to "phase" Willoughby's infrastructure was primarily a cost-cutting measure, rather than a fear of carrying infrastructure costs as claimed.

Development Cost Charge History (1991-2024)

How the fee freeze strategy supported rapid Willoughby development

Key Insight: The chart below shows how development fees remained essentially frozen from 2007-2019, subsidizing growth during Willoughby's main development period. The highlighted yellow area represents this 12-year freeze.
DCC Components

Phase 3: The Debt-Financed Approach

2020s: Addressing infrastructure deficits through borrowing and record-high fees

Following the 2022 municipal election, a new council faced pressure to address infrastructure deficits in Willoughby while pursuing additional community priorities. This led to a strategy combining record-high development fees with significant borrowing.

The New Financial Model

The current approach represents a significant shift from the previous fee-freeze strategy:

Increased Revenue
  • Development Fees: ~$42k (2021) to ~$73.5k per unit (2024)
  • Community Amenity Contributions: Added in 2018
  • Expanded Scope: Beyond basic infrastructure
Debt Financing
  • Authorized Debt: $168M to $668M
  • Actual Debt: $167M (2023) to $584M (2025)
  • Major Projects: Smith Athletic Park ($154.7M)
  • Infrastructure: Road widening, facilities

A key assumption of this model is that development fees, particularly Community Amenity Contributions, would repay the debt incurred for capital projects. The Township proceeded with major projects like Smith Athletic Park and the LEC Ice and Dry Arenas on this basis, accumulating approximately $144 million in project debt to be repaid through future CAC collections.

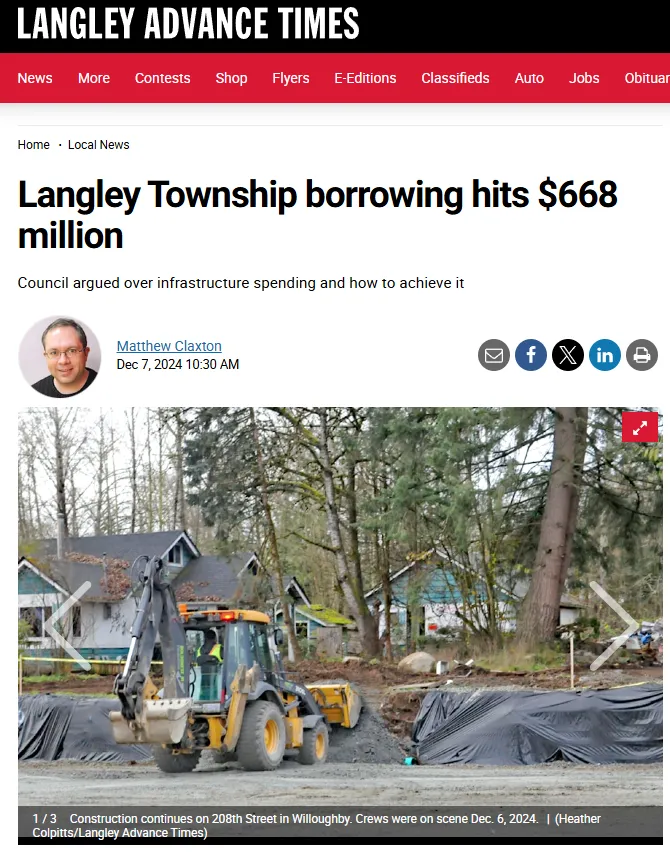

$668 million debt article
Media Coverage

Growing attention to unprecedented debt levels and financial strategy changes.

CAC court ruling article

Legal Development

Supreme Court ruling on Community Amenity Contributions creates revenue uncertainty for the current financial model.

The CAC Ruling and the Repayment Gap

Community Amenity Contributions (CACs) are negotiated contributions toward amenities like recreation centres, libraries and parks that Development Cost Charges cannot fund. In June 2025 the BC Supreme Court found the Township's CAC policy invalid because it worked as a mandatory payment regime (Lorval Developments Ltd. v. Langley (Township), 2025 BCSC 1148). The ruling did not make CACs illegal in BC, but it removed the Township's ability to require them, and the facility debt they were meant to repay was already drawn.

The Province's replacement, Amenity Cost Charges (ACCs), can only fund future amenities and cannot repay debt for projects already under way. Repaying the roughly $144 million in facility costs now depends on voluntary CACs from in-stream projects and on general revenue. In at least one case, a developer of a proposed 39-storey tower offered about half of what the previous policy would have required.

Are CACs legal? Yes, when they are genuinely negotiated rather than required. We have collected the ruling, every major report and legal commentary, and a table of BC municipalities that use CACs on a dedicated page: Are CACs legal in BC?

Economic Context

The strategy assumes continued growth to service debt obligations. However, broader economic factors may affect this assumption, including significantly reduced Canadian population growth which could lead to reduced housing demand.

Phase 4: The Fiscal Constraints Emerge

2026: Borrowing capacity constrained, reserves redirected, costs deferred

The Draft 2026-2030 Financial Plan, presented to Council on February 23, 2026, shows a municipality that has used most of the financial tools available to manage the current budget cycle. While the headline property tax increase of 3.98% (adopted at 3.97% on March 23, 2026) appears modest, the five-year projections and underlying financial manoeuvres reveal significant structural pressures.

From 18.24% to 3.97%: How the Reduction Was Achieved

The 2025 budget projected an 18.24% property tax increase for 2026. The draft came in at 3.98%, and Council adopted 3.97%. How was this accomplished?

Moving Facility Costs off the Borrowing Limit

The Smith Athletic Park and Ice and Dry Arenas still needed $79 million. Rather than borrow it externally, which would have used up most of the Township's remaining room under the provincial Liability Servicing Limit, the budget lends the money from three reserves set aside for parkland, sewer works and public works equipment, to be repaid over 30 years at 4.69%. This keeps the costs off the 2026 tax bill and off the borrowing limit, at the expense of the reserves. We break down the borrowing room, the internal loans and the Housing Trust on The True Debt.

4
$10.1M in Debt Servicing Covered by Reserves (One Year Only)

Separately, $10,121,286 in "Capital Debt Servicing" was classified as a one-time item funded from reserves (E.5 Page 6). The budget does not specify which reserve or which capital debts this covers. Because one-time items funded from reserves have no impact on the tax rate, this removed roughly 5.3 percentage points from the 2026 headline.

This coverage expires in 2027. The "Transfer from Own Funds" line drops from $15.9M in 2026 to $5.5M in 2027, a gap of $10.4M that must be replaced by property taxes. This is a major driver of the projected 22.80% increase for 2027.

2026: Reserve Transfers In
$15.9M from reserves
Includes $10.1M one-time capital debt servicing coverage.
2027: One-Time Coverage Expires
$5.5M
$10.4M gone
The gap must be replaced by property taxes.
Borrowing for routine maintenance

Three borrowing bylaws for routine maintenance were passed. They move expected maintenance costs, typically taken from the operating budget, into debt servicing. This defers the immediate tax impact and highlights a lack of capacity to cover these costs from ordinary reserves.

Borrowing Bylaw Description Long-term borrowing Amount
6084 Road replacement (Old Yale Road) Spring 2026 $6,959,596
6110 Culvert Replacement Spring 2026 $12,818,182
6127 Roof Replacement Spring 2026 $9,858,586
$29,636,364
2026 Total Property Taxes (actual) $192,027,242
2026 Total Property Taxes (if this maintenance was paid upfront instead of borrowed) $221,663,606
Effective Tax Increase 20%
Source: Mike Parker's TikTok. When the borrowing bylaws are included alongside the proposed property taxes, the effective tax increase is approximately 20%, not 3.97%.
Other mechanisms
  • $7.3 million in other one-time items funded from prior year surplus and reserves (election costs, contingencies, LED displays, critical road reconstruction, studies)
  • $1.425 million reduction in the transfer to the capital projects reserve
  • $1.25 million in operating efficiencies, the only permanent structural savings

Comparing the five-year projections from both budget documents shows that the cumulative totals are nearly identical. The year-by-year distribution shifted, but the overall magnitude did not:

Budget Document 2025 2026 2027 2028 2029 2030 Cumulative
2025 Budget projections 4.50% 18.24% 8.16% 5.94% 4.83% - ~41.7%
2026 Draft projections - 3.97% 22.80% 4.79% 4.21% 4.43% ~40.2%
= actual or proposed rate for the current budget year. Remaining years are projections.
Key Observation: The five-year cumulative totals are nearly identical (~41.7% vs ~40.2%). The 2026 increase was smoothed from 18.24% to 3.97%, but the projected 2027 increase grew from 8.16% to 22.80%, largely because the $10.1M one-time item expires and those costs return to the tax rate. When the borrowing bylaws are factored in, the effective 2026 increase is approximately 20%.

Debt and Borrowing Room

$584.4M
External debt, Dec 31, 2025 (up from $317.3M)
$79M
Borrowed internally from reserves in 2026
~$11M/yr
Debt servicing room left, per the 2026 budget
$33M → $64M
Budgeted annual debt payments, 2025 to 2030

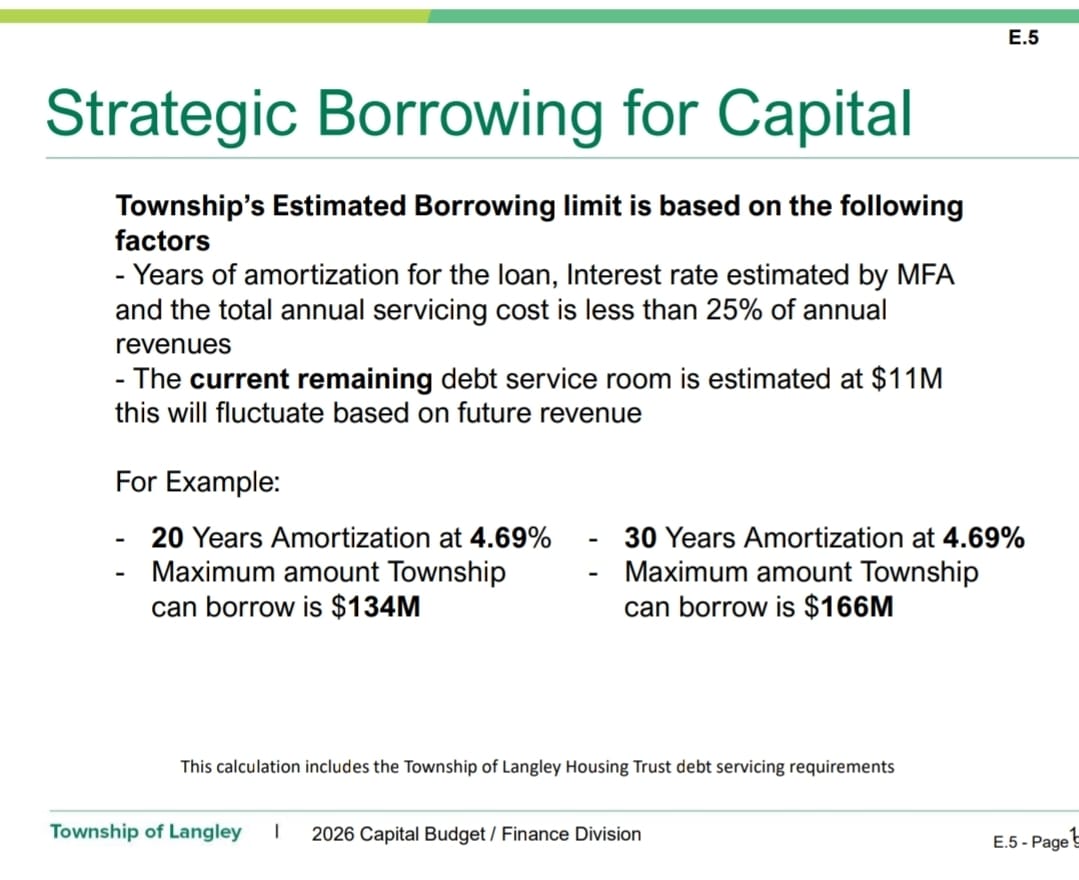

How much can the Township still borrow? The 2026 budget says about $166 million over 30 years. In April the Township told CBC it could borrow another $350 million. We reproduced the budget figure exactly, and the gap comes down mostly to whether the Housing Trust's planned $177 million of debt is counted. Neither figure includes the $79 million borrowed internally from reserves. Read The True Debt for the full reconciliation, the borrowing limit, the internal borrowing and the Housing Trust.

Structural Cost Growth

Beyond the capital financing constraints, the operating budget reveals structural cost pressures growing faster than the revenue base:

Protective Services (77% of 2026 increase)

RCMP contract costs increase $2-2.5M annually, largely outside municipal control. The plan adds 2 officers in 2026, 3 in 2027, and 2 in 2028. Fire services are adding 16 firefighters in 2026 alone, with 6 more planned for 2027.

Debt Servicing

Debt principal and interest payments were budgeted at $33.0M in 2025 ($28.3M actually paid), $47.7M in 2026, and are projected to reach $64.2M by 2030, nearly double. This does not include internal borrowing repayments.

New Facility Operating Costs

The LEC Ice and Dry Arenas (opening August 2026) add $1.166M in operating costs for five months. Fire Hall #5 adds another $109K. These costs grow in 2027 as full-year impacts are realized.

Utility Rate Pressures

Sewer rates increased 28.69% in 2025 (62% driven by Metro Vancouver's North Shore Wastewater Treatment Plant). Regional sewerage charges are projected to climb 5-9% annually through 2029.

Sources

All figures on this page are drawn from the Draft 2026-2030 Capital and Universal Operating Financial Plan, the 2025 Budget and Operating Plan, the Township of Langley 2025, 2024 and 2023 Annual Reports (Financial Sections), and the June 2025 Liability Servicing Limit Certificate obtained via FOI. The borrowing bylaw and "Apples to Apples" effective tax increase analysis was contributed by Mike Parker.

Municipal Finance History (2007-2025)

Revenue, debt, and development contributions through all four phases

Key Insight: The chart below shows the dramatic debt increase starting in 2024, from $167M at the end of 2023 to $584M at the end of 2025, illustrating the shift to a debt-financed approach for addressing infrastructure deficits and expanding municipal services.
Financial Indicators

Current Context and Financial Sustainability

Converging Risks

The Phase 4 analysis reveals that the Township's financial strategy now faces multiple simultaneous constraints. The assumptions underlying the debt-financed approach in Phase 3 are being tested:

Borrowing Capacity Constrained

Approximately 86% of the statutory borrowing limit is consumed, including Housing Trust obligations, leaving limited room for conventional municipal borrowing.

Reserves Committed

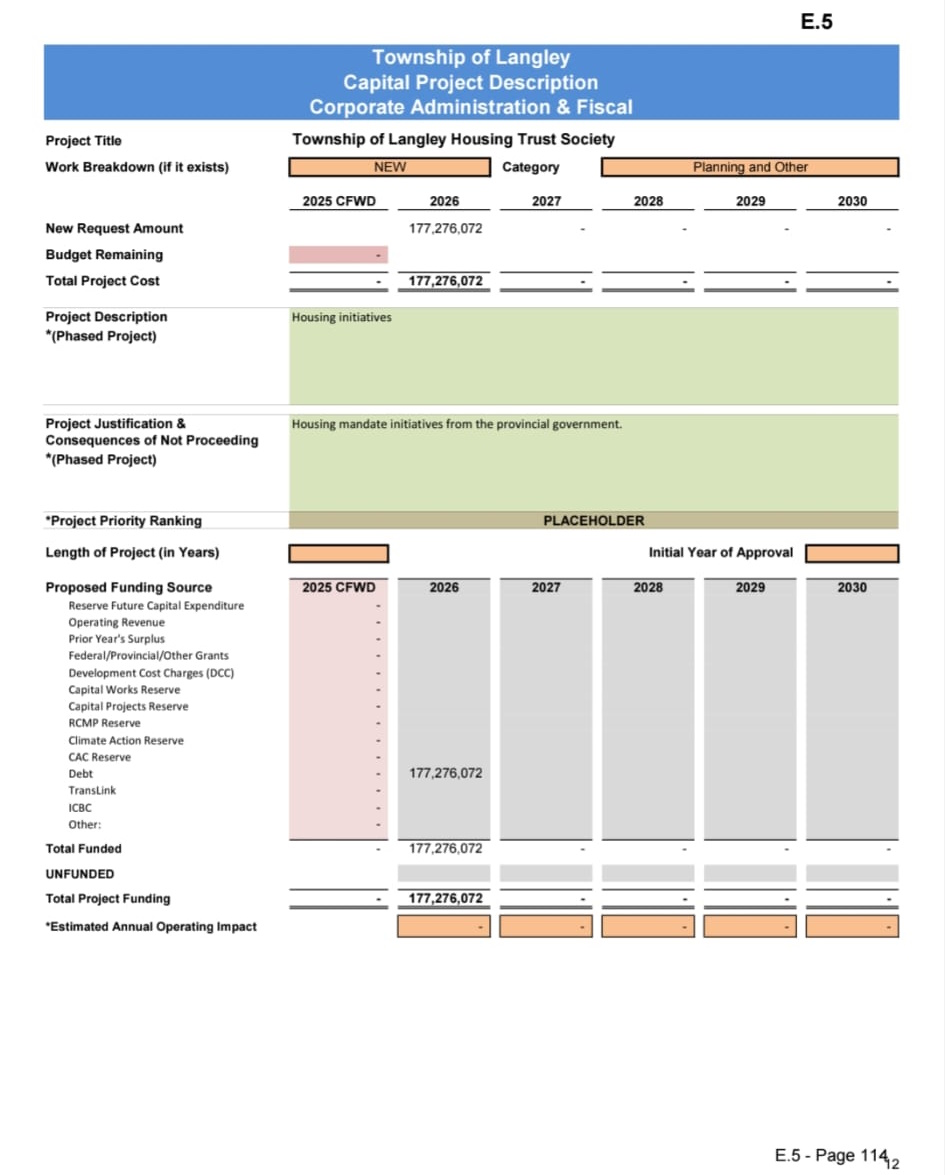

$79M internally borrowed from purpose-specific reserves. General Capital Reserve held just $195K at the end of 2025, and the Debt Retirement Reserve $736K, down from $7.6M at the end of 2023.

Legal Framework Uncertain

Court ruling on CACs creates revenue uncertainty; CACs are also the planned repayment mechanism for the $79M internal borrowing.

Structural Costs Accelerating

Debt servicing nearly doubling (from a $33.0M budget in 2025 to $64.2M in 2030), protective services consuming 77% of annual budget growth, and new facility operating costs compounding.

Growth Dependency Persists

Debt servicing and internal borrowing repayment depend on continued development activity, while national population growth has slowed and tariff uncertainty clouds the economic outlook.

Historical Pattern

Each phase has followed a consistent pattern: an initial strategy generates growth but creates new obligations, which are then addressed with increasingly aggressive financial tools, which in turn create further constraints.

The Cycle
  • Phase 1: Infrastructure-first development during a downturn created fear of front-loading costs
  • Phase 2: Fee freezes subsidized growth but created infrastructure deficits
  • Phase 3: Record borrowing and high fees addressed deficits but created massive debt obligations
  • Phase 4: Debt obligations and structural costs have consumed most of the statutory borrowing ceiling; the 2026 budget relies on one-time reserve-funded debt servicing coverage and cost reclassification to manage the current year's tax increase, while borrowing bylaws add a further $29.6M in committed obligations
The Core Question

Based on the Township's own five-year projections, the cost structure is growing faster than its revenue base. Each budget cycle has used more of the remaining financial flexibility to smooth the gap. With borrowing capacity at approximately 86%, major reserves lent out, and a 22.80% tax increase projected for 2027, the available tools for continued deferral appear limited. The Strong Towns framework identifies this as a common outcome of growth-dependent finance: the obligations of past growth consume the resources needed for future resilience.

Sustainable Development Alternatives

The Strong Towns methodology emphasizes building community wealth through incremental development that doesn't require municipal subsidies or create long-term financial obligations.

Incremental Development
Infill Development

Encourage density in existing neighborhoods with established infrastructure and proven demand.

Mixed-Use Zoning

Allow neighborhood businesses and diverse housing types to develop organically. Commercial pays higher property tax rates, improving financial performance in residential areas.

Adaptive Reuse

Maximize value from existing built environment and infrastructure investments.

Value-per-Acre Focus

Prioritize areas that generate sufficient tax revenue to sustain their infrastructure.

Financial Resilience
Infrastructure Optimization

Upgrade existing systems rather than building new ones that create additional maintenance obligations.

Lifecycle Cost Analysis

Full accounting for maintenance and replacement costs over infrastructure lifespan.

Diversified Revenue

Reduce dependence on development fees through sustainable tax base growth.

Phased Implementation

Match infrastructure investment timing to demonstrated demand and financial capacity.

Strong Towns Approach

This approach allows communities to grow organically based on market demand while maintaining financial resilience. Rather than requiring subsidies or creating long-term obligations, incremental development builds community wealth gradually and sustainably.

Get Involved in Community Financial Planning

Informed Community Engagement

Understanding municipal finance helps residents make informed decisions about community development priorities and evaluate the long-term sustainability of growth strategies.

Public Participation
  • Attend municipal council meetings
  • Ask questions about long-term financial sustainability
  • Review annual budgets and debt levels
  • Examine infrastructure maintenance plans
Development Advocacy
  • Consider financial implications of proposed projects
  • Support zoning reforms for incremental improvement
  • Advocate for value-per-acre analysis
  • Promote financially sustainable development patterns
Join WhatsApp
Financial Transparency

Join us in advocating for financially sustainable development that strengthens our community's long-term prosperity.

Stay Informed
